Tuesday, November 22, 2011

Day 281 (Week 41) [+57]

The Painter returned today do do a second coat on the front of the house, and he completed it just in time as the rain came tumbleing down... Also and FINALLY... they started to repair the bath tub in the main bathroom... just intime for our walk through tomorrow.



Monday, November 21, 2011

Day 280 [+56]

Workers were onsite today with a fair bit of work done to the outside. - Painter painted the downpipes and the front of the house (the right colour this time) the angle plates we installled above the doors and windows. and some trimming added to where it was needed on the balcony. Also the Expansion Joints were sealed and siliconed up!

they may just make it by wednesday for our PC walkthrough.....



Expansion Joints


Kitchen Window

Front Entry

Tuesday, November 15, 2011

Day 274 (Week 40) [+50]

Well Metricon decided to pull their finger out and actually organise some work for the house... the painter returned to site as well as the balcony guy to fix off the stainless steel barrier. Termite protection lookslike it was mostly installed too..

The Front looks nice now it is all stained again.



Termite Protection


Entry

Knock Knock


Porch


Monday, November 14, 2011

Day 273 [+49]

Today the cleaners returned to clean the second half of the front yard... and there was a meeting onsite with the construction team...Maybe they were figuring out how to stuff things up even more, because it is pretty clear they are in no rush to deliver the house anymore... Metricon are wasting time and have a book of excuses. they still cannot tell us a date for practical completion...when they decide to call us back that is.!

Not a happy person right now.

Sunday, November 13, 2011

Saturday, November 12, 2011

Day 271 [+47]

Not A Single Solitary Person Stepped on site today. Still no sign of the painter.. Lucy didnt even want to visit... There really isnt a point if the builder cannot be bothered to get any trades out to do any work...

Friday, November 11, 2011

Day 270 [+46]

today was to be the revised date for out practical completion walk through... but it was cancelled as the house is not in a state to be presented (no kidding its not finished)

with the scaffold coming down and the cleaners were on site to clean up the inside of the house.. and it did scrub up pretty nice.

still a bit of work to do however..when will it be finished?? good question... i have no idea and no one can tell us.

Tuesday, November 8, 2011

Day 267 (Week 39) [+43]

 The days just keep ticking over and so does the lack of progress on the house... some would think they have never built a house before. Nothing Today...Again

Monday, November 7, 2011

Day 266 [+42]

Guess what happened today..

Absolutly Nothing!!

not a happy person right now.. and to top it off they can not even tell us when they will finish the house..


:(

Sunday, November 6, 2011

Day 265 [+41]

Sunday today and after the tilers were onsite yesterday i though maybe... just maybe the painters may just be on site today..

But No...Expected...but Disapointing

No Work today

I dont think Metricon are serious about finishing the house for us.

Saturday, November 5, 2011

Day 264 [+40]

wow 40 days over the original contracted date.. this is a very very disapointing milestone to reach, and it saddens me every time i look at the house...

But when i walk through it i am reminded how nice a house it is.. a shame the builders have no pride..

Today the Tilers were on site Grouting the floors of the wet areas.. the bathrooms are starting to look really good.

cant wait to see what they look like whennt hey are all nice and clean!!


Porch

Balcony

Balcony

Laundry

Main Bathroom

Friday, November 4, 2011

Day 263 [+39]

Wow a disapointing day today it was supposed to be our practical completion walkthrough today but we have not heard a single peep form anyone from Metricon to confirm or explain why it did not happen.,

Not a single trade was on site either :(

Thursday, November 3, 2011

Day 262[+38]

Tilers Returned to site today and they laid the tiles on our Balcony and Porch, the colours have tuned out really well.. They also grouted the tiles in the kitchen.




Wednesday, November 2, 2011

Day 261 [+37]

well another step backwards today with the bathtub in the ensuite removed.....That was all.. i would not even call it a day where work was completed on site

A very disapointing day since we were told two weeks ago that the house would be transformed before our eyes... "Practical Completion" is on friday so they tentativly told us... but i can not see that happening.

Disapointment after disapointment...



De-Construction


Tuesday, November 1, 2011

Day 260 (Week 38) [+36]

Tilers returned to site today and they laid the beds for the exterior tiles on the porch and balcony

The Glass on the front door was also replaced.

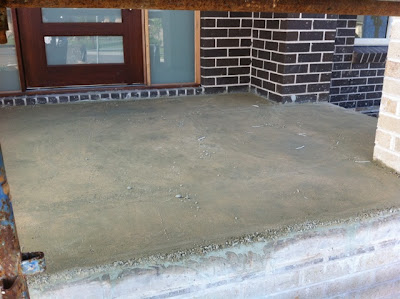

Porch

Balcony

New Glass in door

Monday, October 31, 2011

Day 259 [+35]

Today saw the balcony get fixed (I Hope) and the waterproofing re-done ready for tiling. The tassie oak dressing was also finished on the underside..

I do Really hope it is fixed properly this time


Tassie Oak Dressing

Balcony Repair


Balcony Repair

Water Proofing

Sunday, October 30, 2011

Thursday, October 27, 2011

Day 255 [+31]

Today saw a carpenter onsite to start fitting off the door furniture also our electricity was connected the house is now alive!!


Power


Door handles


Wednesday, October 26, 2011

Day 254 [+30]

Today saw shower screens and mirrors go into our bathrooms, and they  have turned out pretty nice



Ensuite Mirror

Ensuite Shower

Main Bathroom Mirror

Main Bathroom Shower

Powder Room Mirrir

Tuesday, October 25, 2011

Day 253 (Week 37) [+29]

No work on site today, nothing was Scheduled... Lucky as it Pelted rain all day... not that it should of made a difference as there is plenty of work to be completed on the inside still.


It is going to be a busy rest of the week.. "Practical Completion" is dues next week

Watch Out - Rain Days

Watch Out

One thing that has really frustrated and Annoyed me with Metricon is the lost time due to rain days.

They Claim just about everything over 0.4mm and it doesnt matter if they did infact work on that day, if  it was a part day or a full day, external or internal work they will still claim it as there "may" or "may not" be an impact to the timeline where the rain "may" or "may not" cause a delay..

They also Claim Sundays and Public Holidays for the same reason that the rain just possibly "may" or "may not" cause a delay..

I mean they hardley even work a Saturday let alone a Sunday to even warrent claiming it as a lost time delay

It feels like just a cheap excuse to get them out of trouble..

Monday, October 24, 2011

Day 252 [+28]

Today the Brickies finished the columns, this time the top was finished alot nicer as well.. howerver the carpenter returned and did some destruction moving the gable roof timber around to accomodate the fact that it was originally bult off centre.

Latley it seems there is mor steps backwards then there are forwards...



De-construction

another fixer upper
